Material and production evidence

When the Factory Proposes a Material Substitution on a Vanity Order

Treat the request as a decision with three possible answers: approve, approve with conditions, or reject. Classify the change, ask for proof that matches its class, check emission and timber paperwork, and record the first affected unit with the revised drawing, parts list and sample.

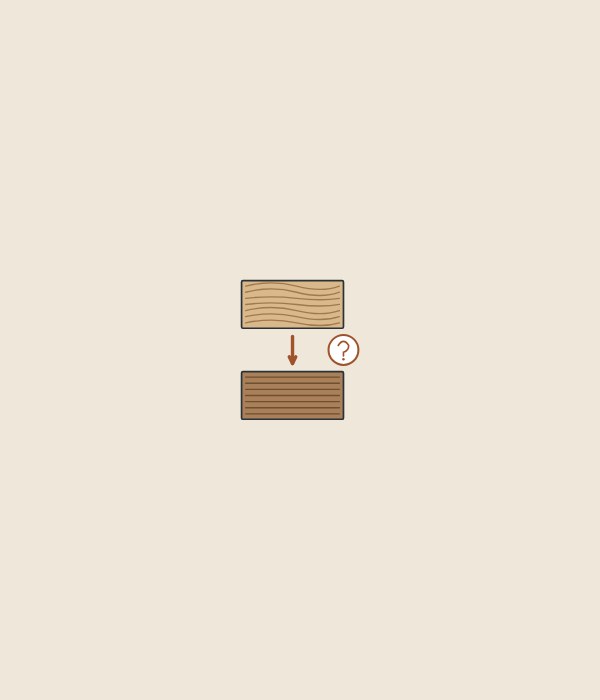

Illustration of a light wood board, an arrow to a darker board and a question mark

Quick reference

Before you answer

Answers
Approve, conditions, reject
First step
Classify the change
Scope
Name the first unit
Panel swap
Check emission records
Species swap
Check import declaration
Close-out
Drawing, list and sample
Illustration of two boards and a request document leading to three outcomes: a tick, a tick with a tag and a cross

Overview

Why a substitution is a decision, not a notice

The buyer’s job is not to refuse every change; some substitutions are harmless. The job is to know which kind this one is, ask for proof in proportion to the risk, and record what was agreed.

What this guide covers

  • Five classes of change
  • How panels, veneer and coatings differ
  • US and California panel paperwork
  • Timber species and import declarations
  • Proof, approval note and order wording

Definitions, limits and filing rules on this page belong to the named authorities and associations. None is a WNS Global specification, certification or listing.

From request to record

What counts as a material substitution?

A material substitution is any change to a material, part or finish that the approved order names. This guide has in mind a request that arrives after cutting has started: the approved timber lot has run out, or a named drawer runner is on back order.

ASQ defines change management as the process of planning, validating and implementing a change and verifying its effectiveness. AIAG, an automotive industry body, says on the catalogue page for its Production Part Approval Process manual that its guidelines set the minimum a supplier must document and submit to a customer for approval to ship production quantities.

TermWhat it means
Change managementASQ: planning, validating and implementing a change, then verifying it.
“Equal” itemFAR 52.236-5: equal in the judgment of the Contracting Officer.

How should a buyer handle a substitution request?

Diagram of five stages, request, classify, proof, decide and record, with the decision branching to approve, conditions or reject

Work through the request in a fixed order and classify the change before answering. The six steps are this guide’s procedure; the diagram groups them into five stages.

  1. Name the class of change. If classes mix, answer to the strictest one.
  2. Ask the reason, the first affected unit and the quantity. Hold the decision until the unit is named.
  3. Ask for proof that matches the class. If documents your market expects cannot be produced, the answer is no.
  4. Decide where changed units go. Keep old and new apart by room type unless the part is hidden and works the same.
  5. Confirm price and schedule effects in writing.
  6. Update the drawing, parts list and approved sample together.

A US federal construction clause, FAR 52.236-5, shows how one contract handles the question. The contractor may use an item other than the one named only if, in the judgment of the Contracting Officer, it is equal, and items that lack a required approval are installed or used “at the risk of subsequent rejection”. A private order needs its own wording.

Which class of change is it?

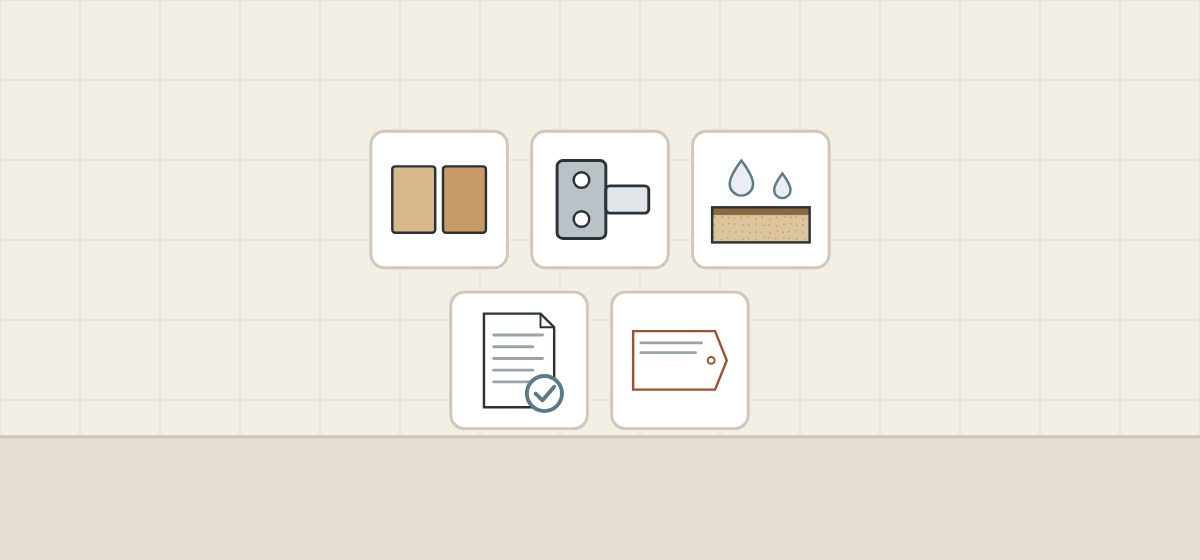

Illustration of five tiles showing color swatches, a hinge plate, a board edge with water drops, a ticked document and a tag

Sort the request into one of five classes; the class sets how much proof to ask for. The classes are this guide’s own scheme.

ClassExampleWhat is at stake
Appearance onlyA new stain batchColor and sheen
Fit and functionA different runner or hinge modelMounting, travel and adjustment
Durability-relevantA different panel core or coating systemHow the part holds up in use
Regulated in your marketA different composite panel or timber speciesEmission and import paperwork
Paperwork onlyA new supplier code for the same itemWhether records still match

CARB’s composite wood regulation requires hardwood plywood, particleboard and MDF, and new finished goods containing them, to meet emission standards and be labeled in California; it names cabinets as an example. A panel change there is a regulated change too.

How do panel, veneer and coating types differ?

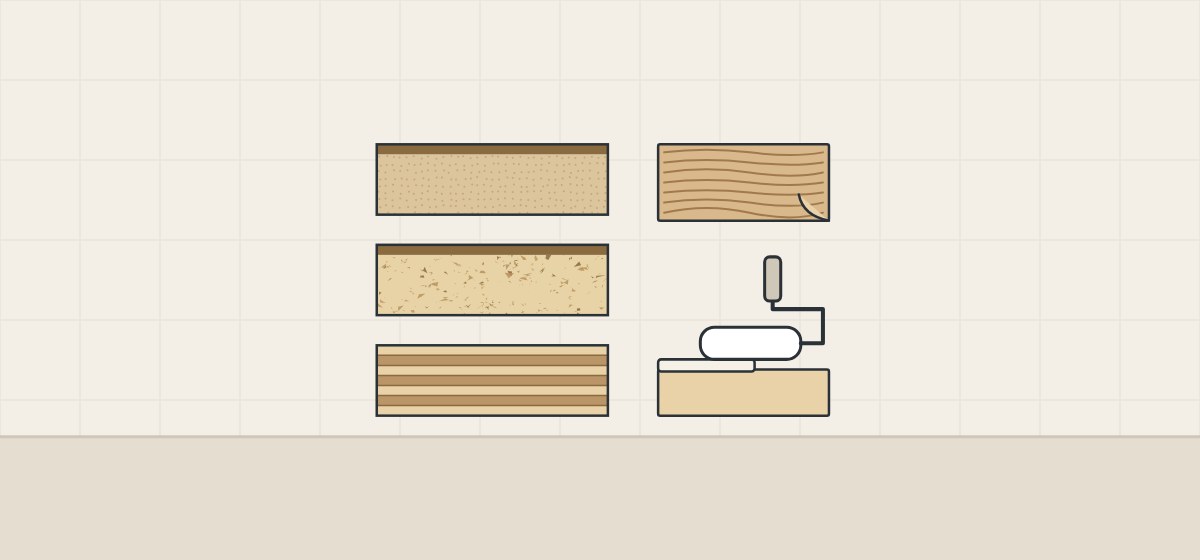

Illustration of three board edges with fiber, chip and layered cores beside a veneer sheet and a roller coating a board

They differ in what they are made of. The descriptions below summarize the trade associations’ own.

MaterialSourceDescription
MDFComposite Panel AssociationTypically cellulosic fibers with a synthetic resin or other bonding system, joined under heat and pressure.
ParticleboardCPACellulosic particles of various sizes bonded with a resin or binder.
Hardwood plywoodDecorative Hardwoods AssociationThree or more veneer layers, each ply’s grain perpendicular to the next.
VeneerDHATypically a very thin hardwood sheet, usually under 1/8 in, applied to another surface.
CoatingsCPAWater-based acrylic latex, solvent-based, UV and powder types.

CPA says particleboard’s resin level and density may be modified for the end use, and that additives can add moisture resistance. DHA says MDF, particleboard, combi-core and lumber can also be used as hardwood plywood cores. So ask for the core and thickness, not only the panel name.

What changes when a composite panel is swapped?

Illustration of a board edge with a label tag, a cabinet with a label tag, a ticked document and a calendar

In the United States, the EPA’s TSCA Title VI rule covers hardwood plywood, MDF and particleboard, and finished goods containing them. Confirm other markets with the local authority.

Veneered parts

The EPA’s stakeholder questions define a laminated product as a wood or woody grass veneer affixed to a particleboard, MDF or veneer core. Producers of laminated products that are not exempt must test and certify them as hardwood plywood producers.

Emission limits

The EPA gives its formaldehyde emission limits as 0.05 ppm for hardwood plywood, 0.09 ppm for particleboard, 0.11 ppm for MDF and 0.13 ppm for thin MDF.

Labels and records

The EPA says finished-goods labels show the fabricator’s name, the production date and a compliance statement, and that fabricators and importers keep supplier compliance statements for three years.

  • Type, core and thickness of the new panel
  • A photo of the new panel’s label
  • The supplier’s written compliance statement

What changes when the timber species is swapped?

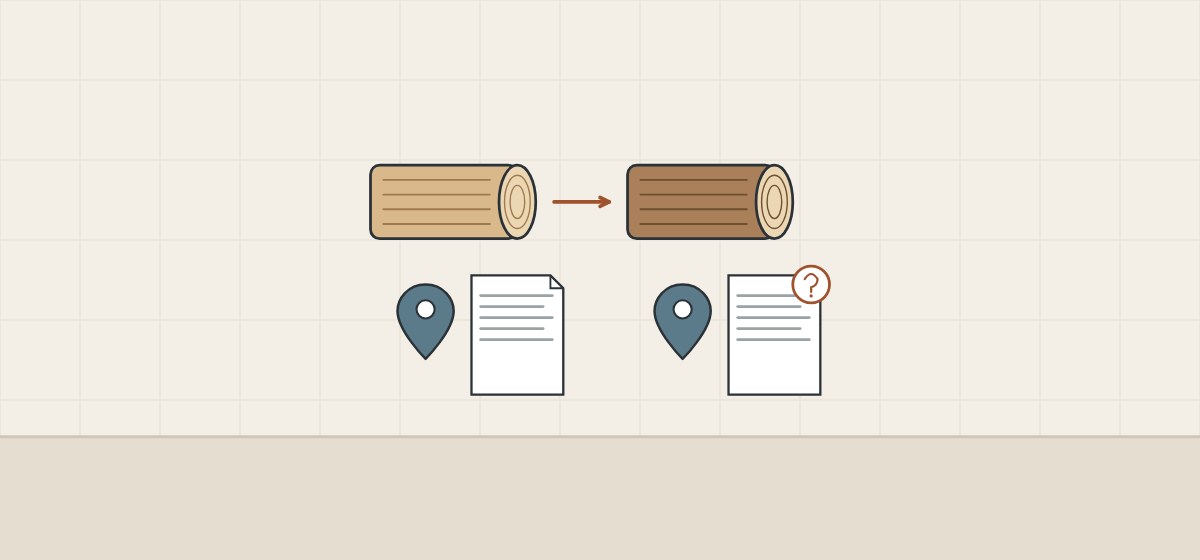

Illustration of a light log and a darker log, each above a location pin and a document

A species swap can change what the importer declares, as well as how the cabinet looks.

US declaration

APHIS says a Lacey Act declaration must give the scientific name, genus and species, of any plant in the shipment, the value of the product, the quantity of the plant and the country where the plant was taken. One condition for needing a declaration is an APHIS-listed tariff code.

Who files

APHIS’s requirements page says only the importer of record or its agent, such as a customs broker, may file. Its questions page says Phase VII includes plant products such as furniture.

European Union

The European Commission says its Timber Regulation prohibits placing illegally harvested timber on the EU market and requires operators to exercise due diligence; the same page says it will be repealed by the Regulation on deforestation-free products. Confirm which applies to your shipment.

Ask for the scientific name and country of harvest, and confirm filing duties with your customs broker.

What proof matches each kind of change?

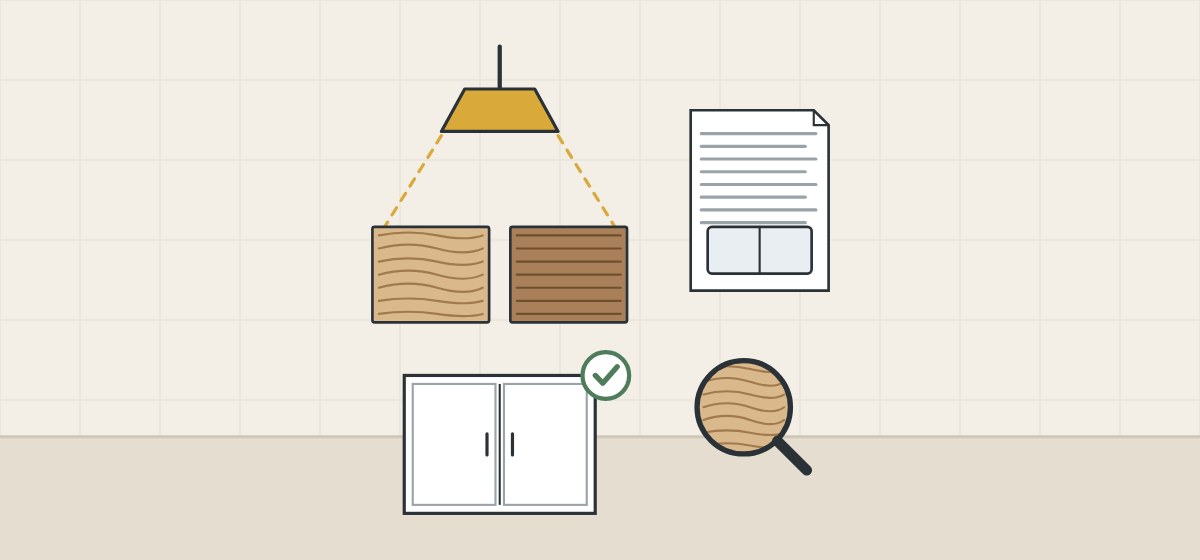

Illustration of two boards under a lamp, a data sheet, a cabinet with a tick and a magnifier over a board

Ask only for what the class requires, but ask before units are built. For equipment approval, FAR 52.236-5 asks for the maker’s name, the model number and performance information, and for samples of materials when directed.

EvidenceWhat it can showWhat it cannot show
Written change requestWhat changes, why, and from which unitHow the new material performs
Old and new samples in one lightVisible color, grain or sheen differenceStability, emissions or wear
Maker’s data sheet for the exact modelStated dimensions and featuresFit in this cabinet
Test fit on a production cabinetThat the part fits and works on that unitService life
Revised drawing and parts listWhat was agreed from the effective unitThat production follows it
New labeled sampleThe reference for the run and reordersThat later units will match

How do substitutions slip past buyers?

Illustration of a message bubble with a cross, a signed document with a tick and three cabinets with one in a different color

They slip past when approval is informal or records are not updated.

  1. Approval by a thumbs-up in a chat. Reply in writing, naming the first affected unit and the documents that change.
  2. The silent swap found at receiving. Put a no-substitution clause in the order and check a first unit against the parts list.
  3. Old and new material in one room type. Allocate changed units by room type or floor before approving.
  4. The approved sample never updated. Replace or annotate the sample on the day of approval.
  5. “Equivalent” meaning only “looks similar”. Ask what it means for this item: dimensions, function, finish, documents.

The one-page approval note

List the item changed, old and new descriptions, the reason, the first affected unit and quantity, the room types receiving changed units, the documents revised, the new approved sample and any price or schedule change. Both sides sign and date it.

What should you send and ask before a quotation?

Illustration of a document, a message bubble, a cabinet and a sample board with a tag

Substitution control starts in the order, before any request arrives.

QuestionWhy it matters
Which species, panels, finish and hardware does the order name?An item the order does not name cannot be controlled.
Is substitution allowed only with written approval?Otherwise the supplier decides what is equal.
Who supplies the panels, and what do their labels state?US and California rules attach to panel type.
Which species and country of harvest will be used?A Lacey Act declaration, where required, names both.
Who holds the approved sample?Reorders are judged against it.

Include with your request

  • Destination market and project type
  • Drawing and component parts list
  • Named species, panel, finish and hardware
  • Room types and quantities

WNS Global confirms any offered product, its materials and commercial terms separately in writing. This guide does not state that WNS Global products use any material named above or hold any certification, listing, label or test result under the rules cited.

Illustration of a light board and a darker board with arrows both ways between two question marks

FAQ

Material substitutions: questions buyers ask

Procedure answers are this guide’s advice.

Which changes need the buyer’s approval?

This guide’s rule: any change to a material, species, panel type, finish system or hardware model named in the order needs written approval.

Can a supplier fit “equivalent” hardware without asking?

Not if the order names the model and requires approval for changes. In US federal construction contracts, FAR 52.236-5 leaves the judgment of what is equal to the Contracting Officer.

What happens to units already built with the original material?

Units built before the first affected unit keep the original material. The packing list should show where changed units begin.

Should a substitution change the price?

A substitution may change the price in either direction. Ask the supplier to state the effect; if the change is for the factory’s convenience, it is reasonable to ask that the price does not rise.

Does a change of timber species need a new sample?

In this guide’s procedure, yes: the run and every reorder need a physical reference in the new species.

How can a buyer stop silent substitutions on reorders?

Reissue the approved parts list and sample reference with every reorder, ask the supplier to confirm them unchanged, and check a first unit on arrival.

Does a factory have to test a finished vanity under TSCA Title VI?

Not as a fabricator: the EPA says only composite wood panels must be tested and certified, and fabricators must buy compliant panels. A factory that laminates veneer onto panels itself may have producer duties.

Does the US panel rule reach finished vanities?

The EPA says its TSCA Title VI rule covers finished goods containing hardwood plywood, MDF or particleboard.

Who files a Lacey Act declaration?

APHIS says only the importer of record or its agent, such as a customs broker, may file a Lacey Act declaration.

Is PPAP required for bathroom furniture?

The sources used here do not say. AIAG, an automotive industry body, describes PPAP as defining what a supplier submits for customer approval to ship.

Illustration of a signed document with a tick beside a sample board with a tag

Summary

Classify, prove, decide, record

Classify the change, ask for matching proof, decide where changed units go, and revise the drawing, parts list and sample together.

Key points

  • Three answers: approve, approve with conditions, reject.
  • Name the first affected unit.
  • Keep changed units within whole room types.
  • Panel and species changes can alter paperwork.
  • Put price and schedule in the approval.
