Material and production evidence

Vanity Back and Bottom Panels: Plumbing Cut-Outs, Floor Moisture and Wall Fixing

Specify the back and bottom of a vanity as working parts. Pipes pass through them, a leaking trap drips onto them and the wall fixing runs through the back. Put a rear view and an underside view on the drawing, with cut-outs, edge sealing, service access and wall backing.

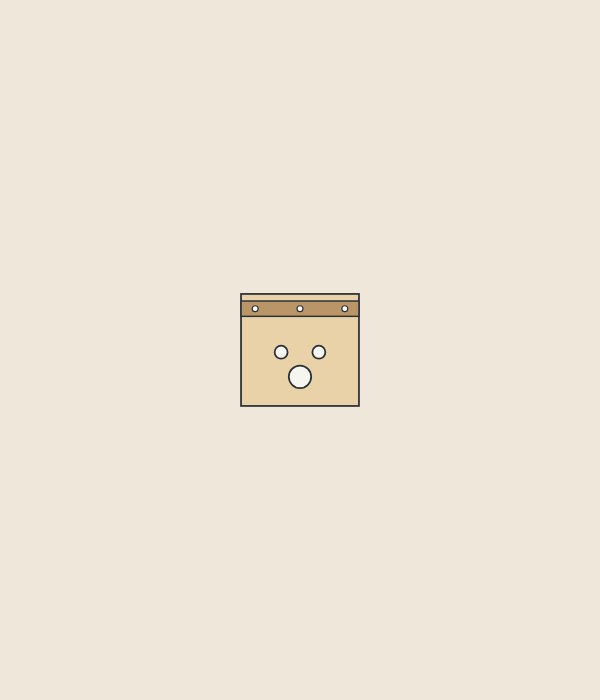

Illustration of a vanity seen from behind, with a fixing rail across the top, two pipe holes and a drain hole

Quick reference

Before the drawing is approved

Back panel
Pipes and wall fixing
Bottom panel
Where a leak lands
Cut-outs
Seal the cut core
Panel edges
Greatest lasting swelling
Access
Trap and valves reachable
Wall backing
In the wall before hanging
Illustration of a vanity front with a turning arrow to its rear view and its underside

Overview

The two panels nobody photographs

The AWI glossary calls the strips on a cabinet back that take the wall fasteners anchor strips. AWI’s installation standard, in its general clause, requires the core exposed by a site cut in factory-finished work to be sealed.

What this guide covers

  • What the back and bottom do
  • How a leak damages a panel
  • Panel materials and water
  • Plumbing cut-outs
  • Access to the trap and valves
  • Wall backing, rails and fasteners
  • Undersides and toe spaces

Sizes, loads and clauses on this page belong to the named makers, guidelines and standards. None is a WNS Global specification, test or listing.

From panel to wall

What do the back and bottom panels of a vanity do?

The back closes the cabinet towards the wall and lets the pipes through.

The 2014 Architectural Woodwork Standards class the underside of a cabinet bottom by its height above the finished floor: concealed below 24 in (610 mm), semi-exposed from 24 to 42 in (1067 mm) and exposed above that. A wall-hung vanity bottom below 24 in is therefore concealed under that scheme.

TermWhat it means
BackAWI: the rear component of a cabinet, opposite the doors or drawers.
Anchor stripsAWI: strips on the cabinet back that take the wall fasteners.
Access panelAWI: a removable panel that gives access to a space behind.
Concealed surfaceAWI: neither visible nor accessible in normal use.

How does a leak damage a back or bottom panel?

Diagram of a wall-hung vanity in side section where a joint drips, water pools on the bottom panel and the cut edge swells

A leak pools on the bottom panel and reaches its edges, where the cited authors find lasting swelling greatest. The sequence combines the EPA’s leak checklist with a chapter on wood and moisture by two Forest Products Laboratory authors.

  1. A joint under the basin drips; the EPA checklist says to look for pooling water under the pipes.
  2. Water collects on the bottom panel.
  3. It reaches a panel edge or the rim of a cut-out.
  4. Wood composition panels swell in thickness; the authors say the permanent part is almost always uneven and greatest at panel edges.
  5. In solid wood, water taken up by end grain can travel for centimeters into a board end.

The same authors write that soaking may bring thickness swelling of 35 to 40 % in densified wood composition materials. The Wood Handbook adds that small amounts of wax slow liquid water pickup for limited periods.

How do panel materials react to water?

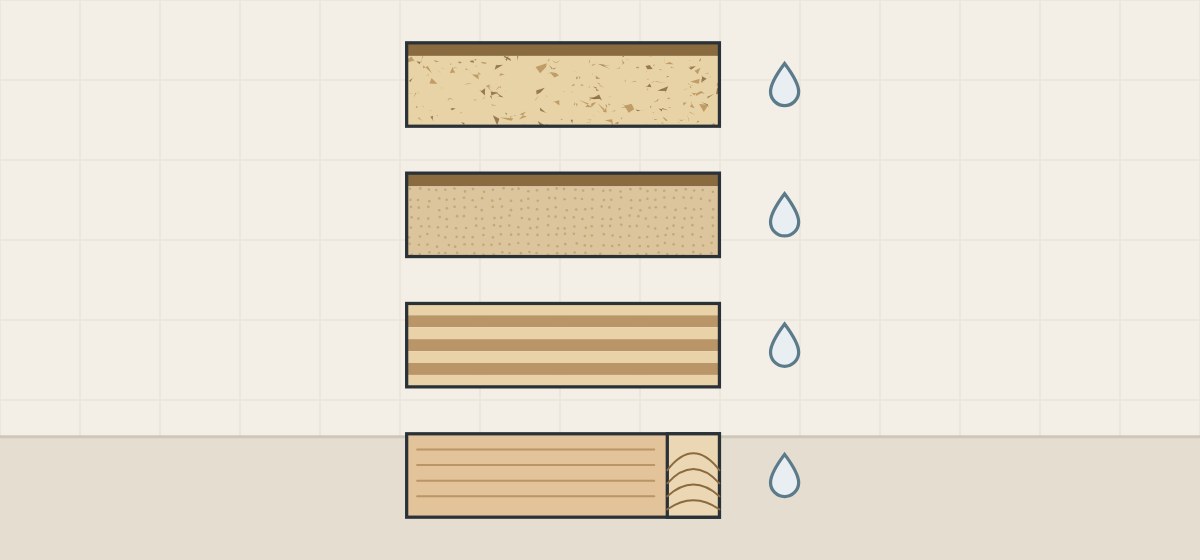

Illustration of four board edges, chip core, fiber core, layered veneer core and solid wood end grain, each beside a water drop

Particleboard, plywood and solid wood each react to water differently in the sources.

MaterialWhat the source says
ParticleboardComposite Panel Association: particles bonded with resin; additives can add moisture resistance.
Plywood when wettedWood Handbook: minimal irreversible thickness swelling, unlike most panels made from particles.
Urea-formaldehyde bondsWood Handbook: typically for interior products, because moisture exposure breaks the bond down.
Solid woodForest Products Laboratory authors: end grain conducts water into the board end.

The Composite Panel Association says ANSI A208.1 classifies particleboard by physical, mechanical and dimensional characteristics and by formaldehyde levels.

Who makes the plumbing cut-outs, and how are they finished?

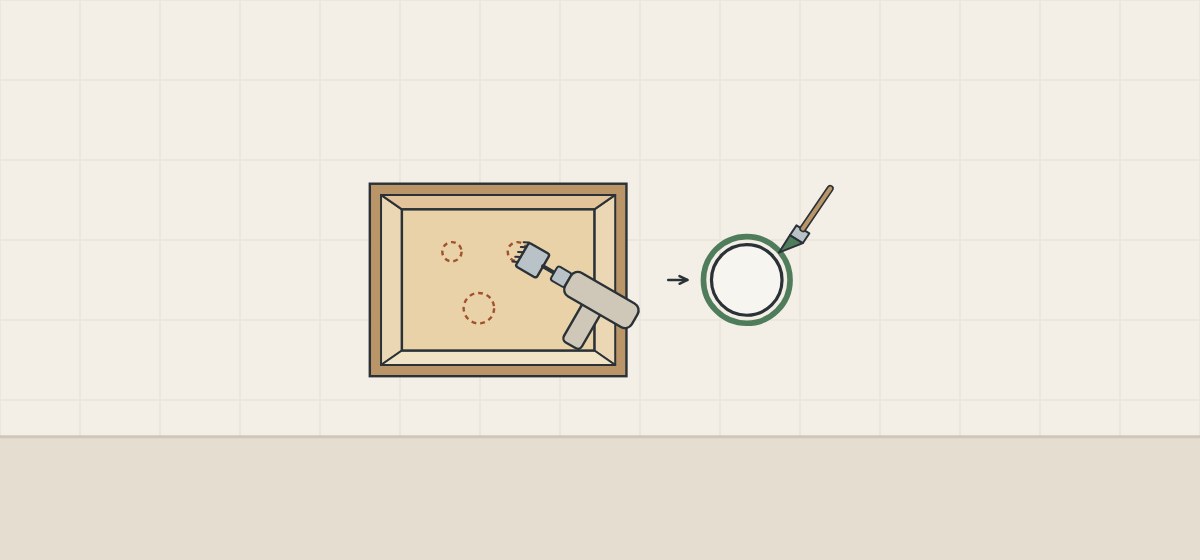

Illustration of an open cabinet seen from the front with a hole saw reaching inside onto one of three marked circles on its back panel, and a cut hole ringed with sealer beside a brush

Three of the four maker documents below have the installer cut the pipe holes on site with a hole saw.

DocumentHow the holes are madeWhat else it says
Kohler 1049900-2-BMarked supply and drain locations cut from inside with a hole saw.Supply nipples extend 3 in (7.6 cm) beyond the finished wall.
Robern 209-1416Stub-outs marked on the back, then hole-sawn from the inside.Locate plumbing so it does not interfere with drawers.
Kohler UK vanity guideMarked locations cut with a suitable hole saw.Edges that may come into contact with water must be sealed.
Kohler 1216526-2-HPlan the plumbing area for the sink.Plan the routing of supply and drain piping.

ANSI/AWI 0620-2024 sets the finishing rule: when factory-finished work is cut or modified for installation, the unfinished core must be sealed before installation. AWI’s casework standard, in its structural clause, allows units that receive sinks to be modified, provided structural integrity is kept.

How is access to the trap and valves kept?

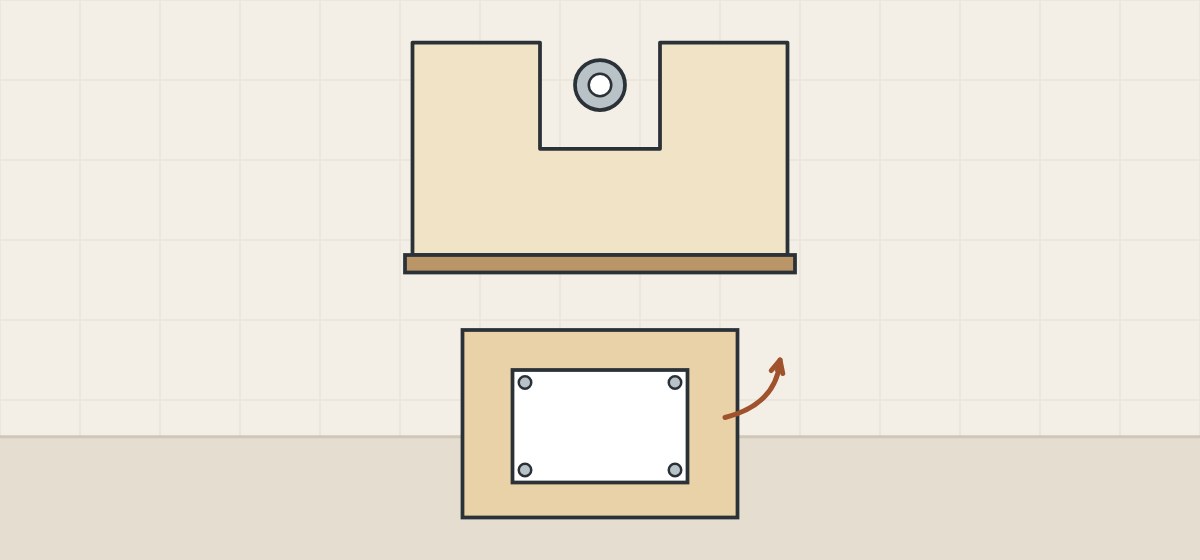

Illustration of a U-shaped drawer seen from above around a pipe and a cabinet back with a removable screwed panel

Access is kept by the drawer layout, by drawers that lift out or by a removable panel. Three points from the sources:

U-shaped drawer

Blum describes a U-shaped sink drawer that uses the space to the left and right of the sink.

Plumbing drawer

Robern’s Cartesian and Profiles (H1 height) instructions list plumbing drawers in three widths and say plumbing installations are not typical with full drawers or its 12 inch vanities. They also say no tools are needed to remove a drawer.

Access panel

AWI defines an access panel as a removable panel that gives access to the space behind.

  • Trap and valve positions on the rear view
  • Drawer type under the basin
  • Any removable back or service panel

How is a vanity fixed to the wall?

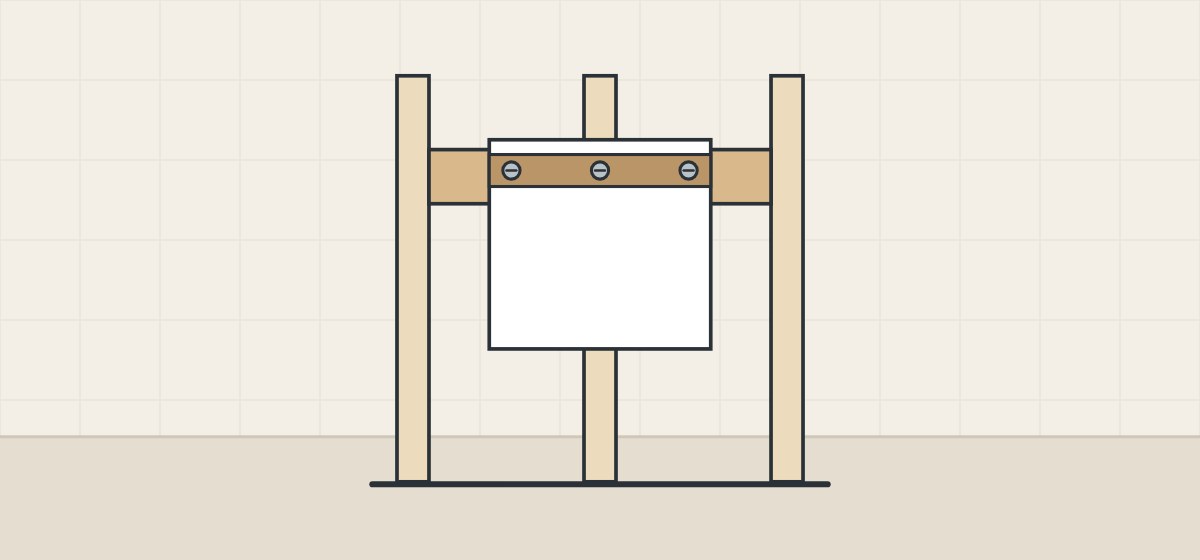

Illustration of wall studs with horizontal blocking and a cabinet back fixed through its rail with three fasteners

In the Kohler and Robern instructions, the cabinet is fixed through a rail, keyholes or brackets into studs or backing in the wall; the Kohler UK guide leaves the fixings to the wall surface. The sizes below belong to the named documents.

Backing in the wall

Kohler’s 1216526-2-H says to secure to stud framing or 2x6 support behind the finished wall. Robern shows 2 x 10 backing for its Cartesian and Profiles vanities and 2x8 blocking for its Helden vanity.

Rail, keyhole or bracket

Kohler’s 1049900-2-B and its UK guide fix through a mounting rail, and its 1216526-2-H through the back rail. In Robern’s Cartesian and Profiles instructions the frame hangs on screws through keyholes; the Helden mounts on steel brackets.

Fasteners

Kohler’s 1216526-2-H asks the installer to select 5/16 in lag bolts it describes as 500 lb load-bearing; they are not provided.

AWI guideline

AWI’s wall anchorage guideline calls for continuous in-wall blocking or backing, at least 2 x 6 in nominal wood or 6 in x 16 gauge flat strapping, installed by others, and allows a hanging cleat if it has been independently tested against the wall cabinet structural integrity test.

ANSI/AWI 0620-2024 has manufacturers provide drawings showing where blocking is required, and installers confirm it is present.

What do the sources say about undersides, toe spaces and floor moisture?

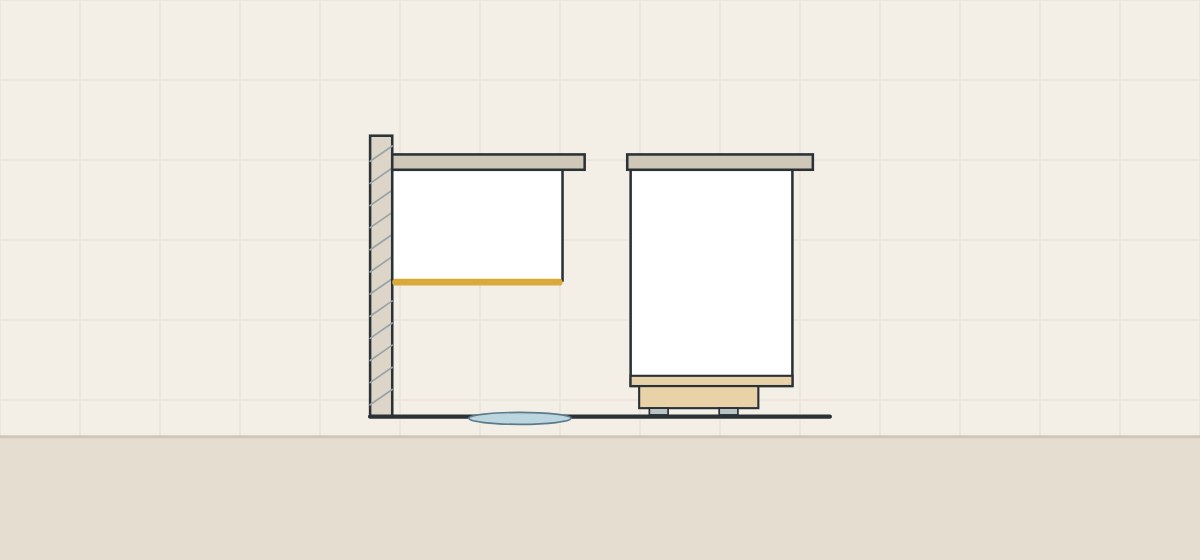

Illustration of a wall-hung cabinet with its underside highlighted above a pool of water, beside a floor-standing cabinet with a toe space

The 2014 standards treat the toe space as a concealed surface unless otherwise specified, and one maker warns about spilled water.

SourceWhat it says
Architectural Woodwork Standards, 2014Toe space is concealed unless otherwise specified; interior faces of backs and bottoms seen only when doors or drawers are opened are semi-exposed.
Architectural Woodwork Standards, 2014Toe-base shimming of up to 1/2 in (12.7 mm) to level casework is acceptable.
Kohler UK vanity guideFurniture may deteriorate under heavy water spillage or prolonged condensation.

How should a buyer specify the back and bottom?

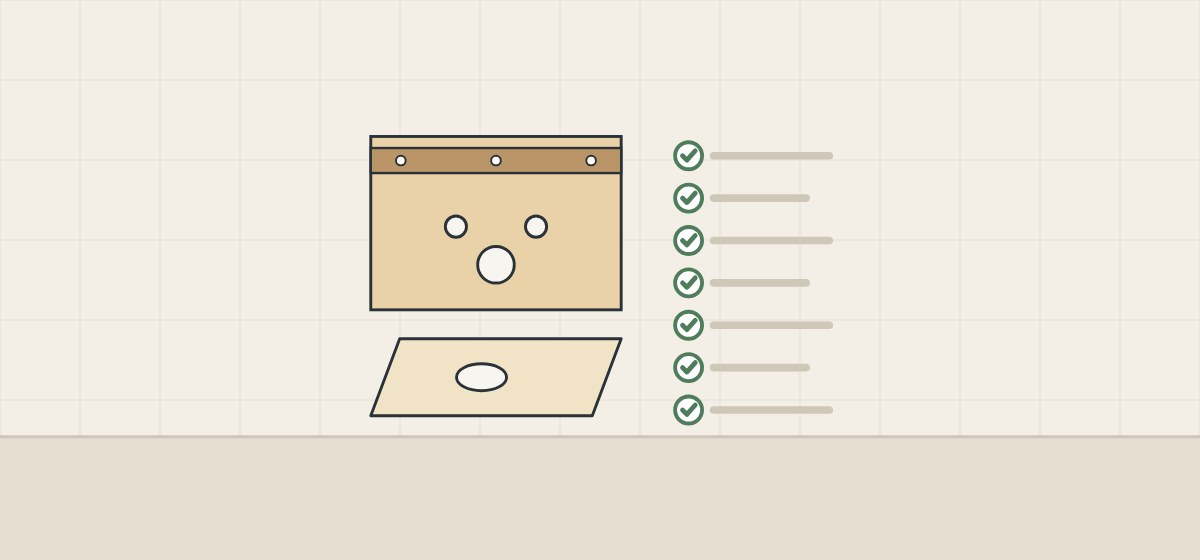

Illustration of a cabinet rear view and underside view beside a checklist of seven ticked lines

These steps apply the facts above before the rough-in is fixed. They are procurement guidance, not an installation method.

  1. Choose the mounting. Wall-hung or floor-standing.
  2. Record where pipes enter. Wall entry puts cut-outs in the back; floor entry puts them in the bottom.
  3. Decide factory or site cut-outs. Factory cuts need confirmed rough-in positions; site cuts need a sealing step.
  4. Plan access. Drawer layout, lift-out drawers or a removable panel.
  5. State the hidden-face finish. Back, underside and cut edges, in writing.
  6. Show the wall fixing. Rail or bracket, fixing points and wall backing.
  7. Check the first unit. Photograph it from the back and from below.

What a photo cannot show

A picture of a neat, sealed cut-out shows its surface on that day, not how long the panel would tolerate a leak.

What should you send and ask before a quotation?

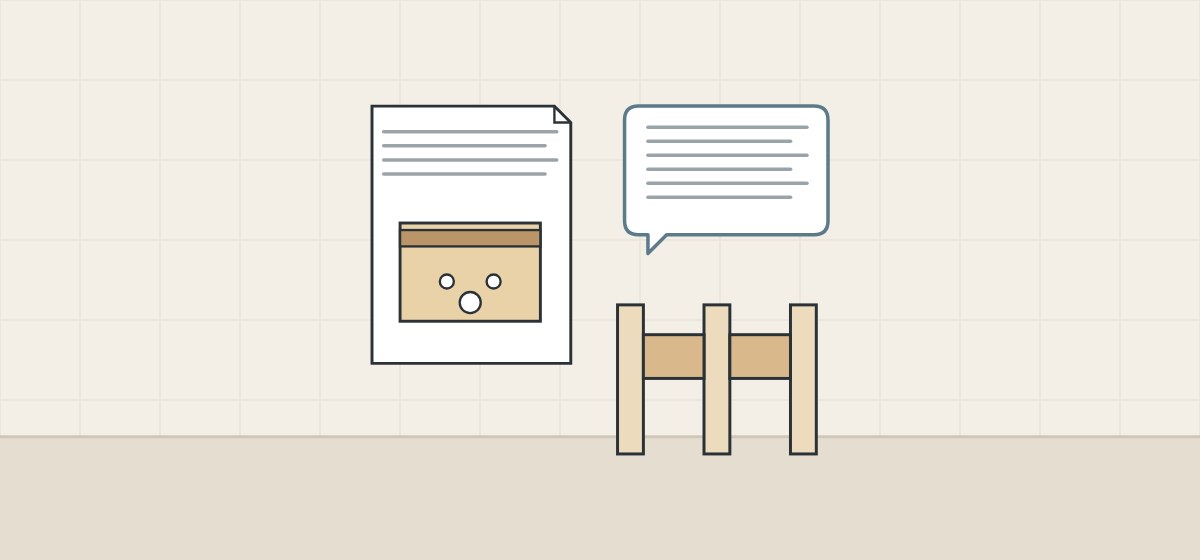

Illustration of a drawing sheet with a cabinet rear view, a message bubble and wall framing with blocking

A complete request shows the rear and underside, not only the front.

QuestionWhy it matters
Which material are the back and bottom?Panel families react differently to water.
Are cut-outs made at the factory or on site?ANSI/AWI 0620-2024 requires the core exposed by a site cut in factory-finished work to be sealed.
How are hidden faces and cut edges finished?The 2014 Architectural Woodwork Standards list the toe space, and undersides below 24 in, as concealed.
How are the trap and valves reached?Robern says plumbing is not typical with its full drawers.
What carries the wall fixing, and into what?Rail, keyhole or bracket; backing goes in the wall first.

Include with your request

  • Rough-in drawing from the plumber
  • Wall construction behind the vanity
  • Wall-hung or floor-standing, per room type
  • Quantity per room type

WNS Global confirms any product and terms it offers separately in writing. This guide does not state that WNS Global products have the features, ratings or listings named above.

Illustration of a cabinet rear view and an underside view between question marks

FAQ

Vanity backs and bottoms: questions buyers ask

Short answers, each tied to the evidence in the guide.

Should plumbing cut-outs be made at the factory or on site?

Three Kohler and Robern documents read for this guide have the installer cut the holes on site with a hole saw.

Must a site-cut edge on a vanity panel be sealed?

ANSI/AWI 0620-2024 requires the unfinished core left by a cut in factory-finished work to be sealed before installation.

What does a trap leak do to a vanity bottom panel?

Forest Products Laboratory authors say permanent thickness swelling of wood composition panels is almost always uneven and greatest at panel edges.

Does plywood swell less than particleboard when wetted?

The Wood Handbook says plywood undergoes minimal irreversible thickness swelling if wetted, unlike most panels made from particles.

How is a wall-hung vanity held on the wall?

Kohler’s 1216526-2-H bolts the back rail into studs or 2x6 support. Robern hangs its Cartesian and Profiles frame on screws through keyholes and shows 2 x 10 backing in the wall; its Helden mounts on steel brackets into 2x8 blocking.

Who supplies the wall fasteners for a vanity?

In Kohler’s 1216526-2-H the lag bolts are not provided; the installer selects them.

Who provides the blocking in the wall?

AWI’s wall anchorage guideline says the blocking is installed by others.

Is the underside of a vanity a finished surface?

The 2014 Architectural Woodwork Standards treat the underside of a cabinet bottom less than 24 in above the floor as concealed.

Can drawers sit under the basin?

Blum describes a U-shaped drawer for sink cabinets, and Robern lists plumbing drawers for its Cartesian and Profiles vanities.

Do plumbing codes require access to the trap and valves?

Code wording was not retrieved for this guide. Confirm access requirements with the local authority.

Illustration of a cabinet rear view above an underside view, with a tick

Summary

Draw the back and the underside

The back and bottom of a vanity carry pipes, catch leaks and take the wall fixing. Fix the rough-in first, seal every cut core, keep the trap and valves reachable and show the wall backing.

Key points

  • Draw rear and underside views.
  • Seal the core of every cut.
  • Lasting swelling is greatest at panel edges.
  • Keep trap and valves reachable.
  • Backing goes in the wall first.
Get A Quote NOW

Sources

Sources and scope

Project review

Send the rough-in drawing and the wall construction

Share where the pipes enter and how the wall is built, and ask what WNS Global can offer. WNS Global confirms any product and terms separately in writing.

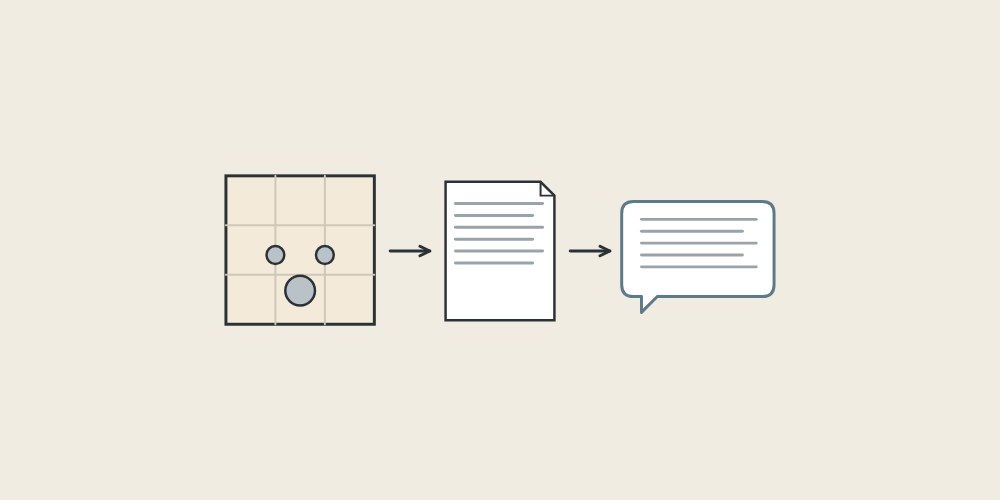

Illustration of pipe stubs in a tiled wall, a drawing sheet and a message bubble linked by arrows
