Shower measurement planning

Should a Shower Enclosure Be Measured Before or After Tiling?

After. Coastal and DreamLine both say a shower door is measured on the finished walls, once the tile is installed. Plan the enclosure type and the wall backing before tiling, but release custom glass only from the finished opening: tempered glass cannot be cut afterwards.

Illustration of a tiled shower opening with three width lines at different heights

Quick reference

Before glass is released

Final measure
After the tile is on
Planning
Before the walls close
Width
At more than one height
Plumb
Read each wall
Allowance
Check the named model
Backing
Hard to add after tile
Illustration of a shower opening in bare framing with a plan sheet beside the same opening tiled with a tape measure

Overview

Two dates: the plan and the measure

Coastal’s FAQ says measuring must be done after the tile or finished wall material has been installed. DreamLine’s measuring guides ask for finished opening measurements only, meaning finished tile or installed acrylic backwalls.

Some decisions cannot wait. The NGA’s frameless shower manual says a suitable attachment substrate is difficult to install after the tile is complete.

What this guide covers

  • When to measure
  • The order of work
  • Tile build-up
  • Measuring points
  • Out-of-plumb allowances
  • Wall flatness
  • Backing and base

Figures here belong to the named maker, manual or quoted standard. None is a WNS Global specification.

From plan to glass release

Should a shower enclosure be measured before or after tiling?

After tiling, for the final measure. DreamLine’s Door Measuring Made Easy guide says all doors should be measured on the finished walls, and its custom glass order form asks for finished wall dimensions, after tile.

The reason is the glass. The NGA manual says cutting, notching, edging and polishing should be done before the glass is tempered, and never to cut or drill tempered glass. A panel made to a pre-tile dimension cannot be trimmed on site.

TermHow the sources use it
Finished openingDreamLine: finished tile or installed acrylic backwalls.
Out-of-plumbNGA: refers to vertical walls.
Center lineDreamLine form: where the glass panels will be positioned.
Tempered glassDreamLine ENIGMA-XO: cannot be cut after it has been tempered.

In what order should backing, tiling, measuring and glass happen?

Diagram of two shower walls in section with four numbered points: backing, tile, measure and glass

Backing first, then tile, then the measure, then the glass. The order is this guide’s reading; each step is the named source’s own statement.

  1. Provide a substrate wherever hinges, clamps, clips or channel will go (NGA manual).
  2. Install the shower base and finished walls (Kohler pivot door).
  3. Measure after the tile or finished wall material is installed (Coastal).
  4. Cut, notch and edge the glass before it is tempered (NGA manual).
  5. Allow new tile cement and grout to dry before installing (Agalite recommends 48 hours).

The Kohler step is from its pivot door instructions. Agalite’s recommendation, in its owner’s manual, is at least 48 hours, so ready to measure and ready to install are two dates.

How much does tiling change the opening?

Illustration of two walls built up from stud, board, mortar and tile, with a stud-to-stud line and a shorter tile-to-tile line

By the thickness of every layer on each wall. DreamLine’s Door Measuring Made Easy guide calculates a door opening as the stud-to-stud measurement minus the thickness of each wall, with its own figures.

Wall or layerDreamLine’s figure
Acrylic wall1 to 1 1/2 in
Ceramic wallMinimum 3/4 to 1 in
Ceramic wall component: gypsum board1/2 to 5/8 in
Ceramic wall component: cement1/8 to 1/4 in
Ceramic wall component: ceramic1/8 to 5/16 in

The last three rows are the components DreamLine lists for a ceramic wall; they are thickness figures, not a recommendation of backing material. A range is not a dimension: the guide still says doors are measured on the finished walls. In an alcove, it adds, a small door adjustment allows for minor variation in the width measurements.

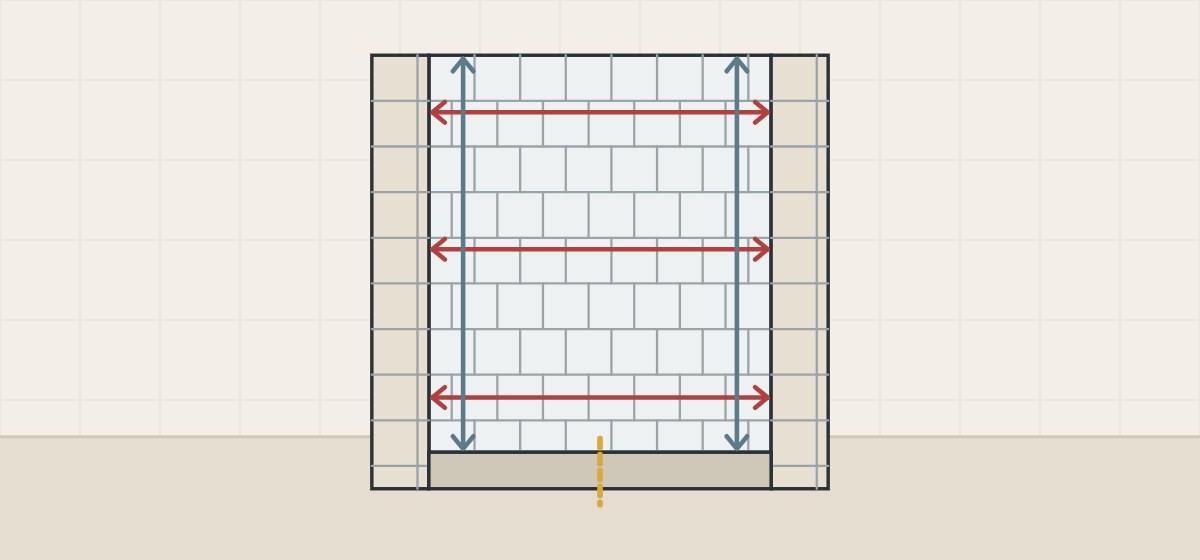

At which heights should the opening be measured?

Illustration of a tiled shower opening with width lines at top, middle and bottom, a height line each side and a center mark on the curb

At more than one height, in both documents below. The points each one asks for are its own.

MakerDocumentWhat it asks for
DreamLineCustom glass order formTop, middle and bottom of finished walls, at the center line.
AgaliteHow to Measure formWall to wall at bottom, middle and top; whether the threshold is level or drops.

The NGA manual says to reconcile widths with the out-of-plumb figures while still on the jobsite. Its example: an opening 30-1/4 in wide at the bottom, with one wall plumb and the other 5/16 in out-of-plumb and growing wider at the top, must be 30-9/16 in wide at the top.

How much out-of-plumb can a shower enclosure take up?

Illustration of a tiled wall leaning away from a plumb line with a spirit level, beside an adjustable wall profile holding glass

It depends on the model, and one model named here takes none. Each figure belongs to its own document.

Kohler

The pivot door instructions require walls within 3/8 in (10 mm) of plumb.

DreamLine

The ENIGMA-XO instructions state no out-of-plumb adjustment: threshold level, walls plumb. The PRIME enclosure instructions describe a 1 in adjustable wall profile system for out-of-plumb walls.

Roman

The Sculptures corner enclosure manual allows no more than 5 mm deviation from vertical and provides a maximum of 5 mm adjustment.

Coastal and Agalite

Coastal says most of its configurations adjust for out-of-plumb; the amount depends on the door series and style. Agalite says a surface more than 3/8 in out of square or level, if not identified during ordering, is generally outside its allowances.

Custom frameless glass

The NGA manual says that when a wall is out-of-plumb but straight, the glass can be cut out of square.

  • Plumb reading, each wall
  • Level reading, curb or shower base
  • Width at each height
  • The model’s stated allowance

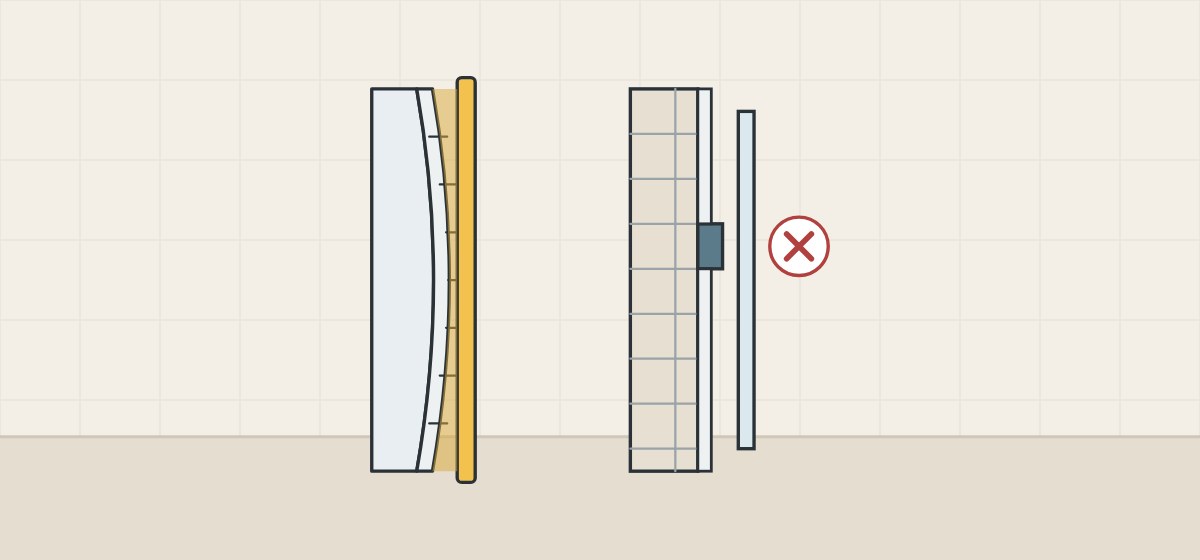

How flat and plumb should the wall be before it is tiled?

Illustration of a wall surface bowing away from a straightedge, beside a protruding tile next to a glass edge marked with a cross

Tile standards limit how far the surface under the tile may vary. The figures are ANSI A108.02 as quoted in TileLetter: tile-work tolerances, not enclosure tolerances.

Plumb, level and true

An article in TileLetter by the Ceramic Tile Education Foundation’s academic director quotes ANSI A108.02: surfaces to receive tile shall be plumb, level and true with square corners.

Flatness by tile size

On vertical surfaces the article gives a maximum variation of 1/4 in. over 10 ft and 1/16 in. over 1 ft for tile with all edges under 15 in, and 1/8 in. over 10 ft and 1/16 in. over 2 ft for tile with an edge of 15 in or more.

Where glass meets tile

The NGA manual says decorative tiles that protrude beyond the wall tile should be avoided within the swing of the shower door.

The Tile Council of North America’s lippage FAQ adds that variations in the plane of the substrate also affect lippage. None of this replaces the plumb reading the enclosure document asks for.

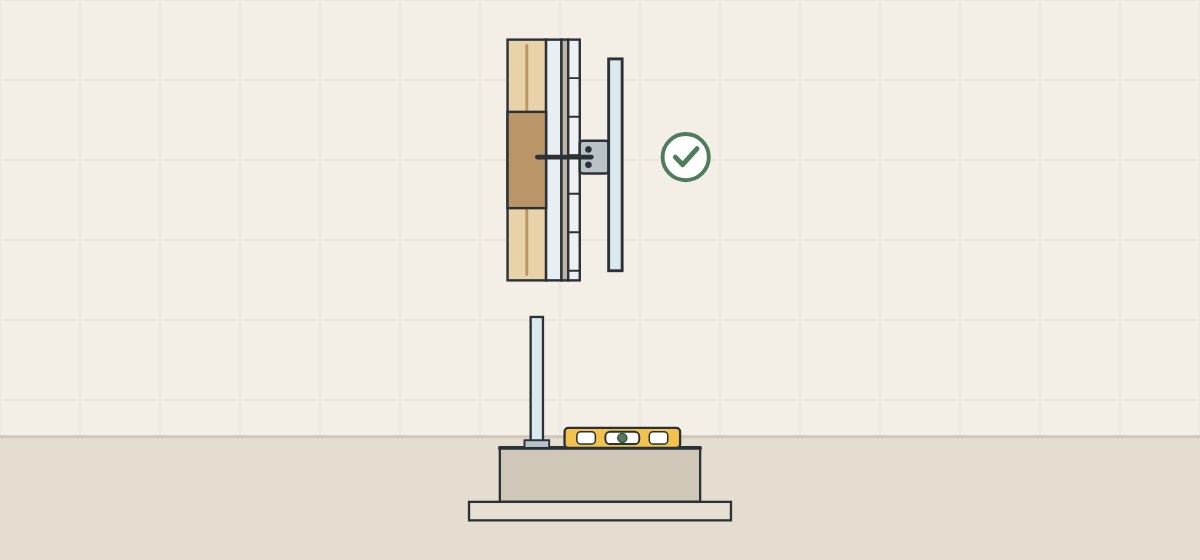

What must be in the wall and under the door before tiling?

Illustration of a hinge screwed through tile into blocking in the wall, above a glass panel on a flat curb with a spirit level

Backing for the fixings, and a flat, level surface for the door. Each row is one source’s own statement.

SourceWhat it says
NGA manualA wood stud directly behind the bedding material is the best backing; tile on drywall with no stud behind the connection point is not normally adequate.
Agalite owner’s manualGlazing channels, fillers, hinges and header blocks go into studs or solid backing beneath the tile.
DreamLine ENIGMA-XOStuds, or 2 x 6 wood blocking between the studs, where the guide rail brackets attach.
Kohler sliding door guideAt least 2-1/2 in (64 mm) of flat surface on the shower base or bath ledge and on the walls; the ledge level between the walls.
TileLetter tech tip, NTCA trainerA door system needs proper structural support and protection of the waterproofing membrane; all parties coordinate before installation begins.

How should a buyer time the measure and the glass release?

Illustration of three stages: framing with a plan sheet, a tiled opening with a tape measure, and a glass panel with a tick

Treat selection, purchase and glass release as three separate commitments. These steps are procurement guidance.

  1. Plan before the walls close. Enclosure type, door operation, hinge side and backing positions.
  2. Select a stock model provisionally. Compare the designed opening with the model’s stated size and plumb allowance.
  3. Ask for a readiness notice per room. Wall tile, curb or shower base and any trim are at their final position.
  4. Measure the finished opening. Widths at each height, plumb and level readings, by a named measurer.
  5. Release glass room by room. Only against that room’s measure and the approved drawing revision.
  6. Reopen approval after any change. A late trim, threshold or wall build-up changes the opening.

If tiling runs late

Before fabrication, move the measure date. After release, ask the supplier at once whether cutting can be held; it has not stopped until the hold is acknowledged. Hold a delayed room; do not copy dimensions from a room that looks identical.

What should you send and ask before a quotation?

Illustration of a document, a message bubble and a tiled shower opening with two width lines

A complete request says what was measured, where and when.

QuestionWhy it matters
Which dimensions do you need, and at which heights?Each maker’s form sets its own measuring points and checks.
What out-of-plumb allowance does this model have?One model named here has none.
Is the glass cut to my readings or to a stock size?Tempered glass cannot be cut afterwards.
Where must backing be, and of what kind?It is difficult to add after tiling.
What flat, level surface does the door need?Kohler’s sliding door states a minimum.

Include with your request

  • Plan with door type and hinge side
  • Finished-opening record per room
  • Plumb and level readings
  • Backing and curb or shower base detail
  • Room types, quantities, readiness dates

WNS Global confirms any offered enclosure, its measuring requirements and commercial terms separately in writing. This guide does not state that WNS Global products have the adjustment ranges, allowances or fixing requirements named above.

Illustration of a tiled shower opening with a width line between two question marks

FAQ

Measuring a shower enclosure: questions buyers ask

Short answers tied to the evidence above.

Can a shower enclosure be measured before the tiles are installed?

Not for the final measure. Coastal says measuring must be done after the tile or finished wall material is installed.

Can I buy a standard shower door while the tiler is still working?

Yes, but the size may not fit. DreamLine’s PRIME instructions say to measure the finished opening to be sure the correct model size was ordered.

Does ready to measure mean ready to install the enclosure?

Not by Agalite’s account: Agalite recommends at least 48 hours for new tile cement and grout to dry before installing.

Where is the width of a shower opening measured?

DreamLine’s custom glass order form asks for the top, middle and bottom of the finished walls, at the center line.

How far out of plumb can a shower wall be?

That depends on the model. Kohler’s pivot door needs walls within 3/8 in (10 mm) of plumb; DreamLine’s ENIGMA-XO has no out-of-plumb adjustment.

Can tempered shower glass be trimmed on site?

No. The NGA manual says never to cut or drill tempered glass.

Can wall backing for a shower door be added after tiling?

Only with difficulty: the NGA manual says a suitable substrate is difficult to install after the tile is complete.

May a contractor add a tile trim after the final measure?

Only after the drawing is reviewed again. The NGA manual says protruding decorative tiles should be avoided within the door swing.

Should all rooms wait if one shower threshold is delayed?

The sources used here do not say. As procurement practice, hold that room and release the others.

Who owns the final site measure of a shower enclosure?

The sources used here do not assign it. Name the measurer and the approver in writing.

Illustration of a tiled shower opening with a glass panel fitted and a tick above

Summary

Plan early; cut glass from the finished room

Coastal and DreamLine ask for finished-wall measurements, and tempered glass cannot be cut. Settle layout, backing and base before the tile; read widths, plumb and level after it.

Key points

  • Final measure after the tile.
  • Backing goes in before the tile.
  • Measure at more than one height.
  • Check the model’s plumb allowance.
  • Release glass room by room.
